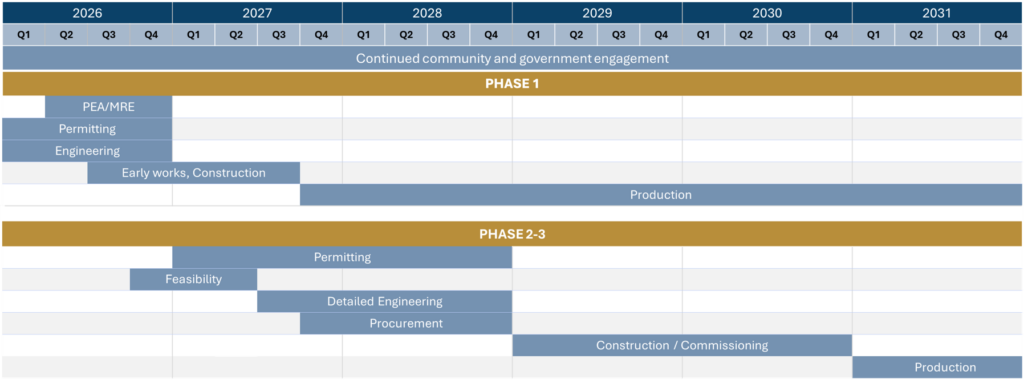

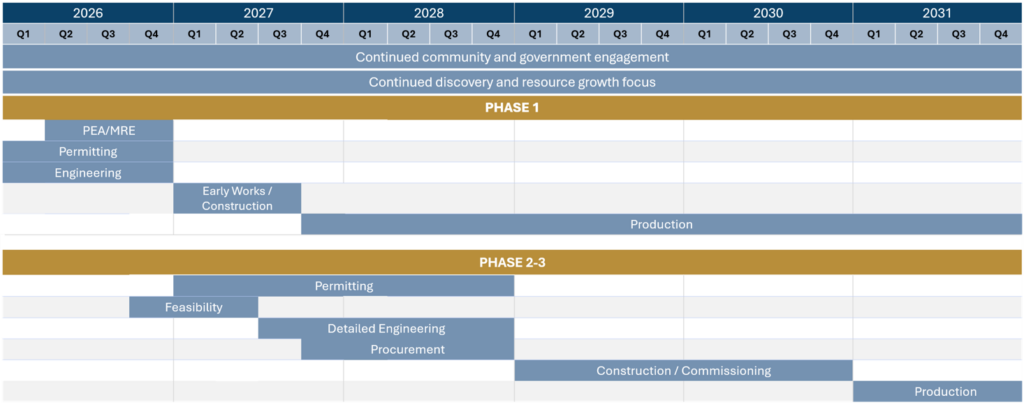

Queensway’s Potential Development Schedule:

  • Geology
    • 2026 90,00 metre drill program underway
    • 55% project focus; 45% discovery & growth focus
  • Engineering
    • WSP commenced Phase I EPCM
    • Site development and detailed offsite mill engineering underway
  • Environmental
    • Baseline studies complete
    • Provincial EA process underway; EPR to be submitted following receipt of guidelines

Logo Pipeda
Privacy Overview

This website uses cookies so that we can provide you with the best user experience possible. Cookie information is stored in your browser and performs functions such as recognising you when you return to our website and helping our team to understand which sections of the website you find most interesting and useful.
